Water Supply Project Eastern and Midlands Region
This project has capacity to address supply water needs for up to 50% of the State’s population.
This project has capacity to address supply water needs for up to 50% of the State’s population.
Planning permission has now been lodged to An Coimisiún Pleanála. Planning documents can be viewed at www.watersupplyproject.ie
Project overview
Our purpose is to deliver transformative water services that enable communities to thrive. For the Eastern and Midlands Region, rising to this challenge requires a new water source.
Today, we have just one source to supply 85% of the water for the Greater Dublin Area – the River Liffey. This dependence on the Liffey (and the two main treatment plants of Ballymore Eustace and Leixlip) results in a serious vulnerability to risks such as prolonged drought and/or contamination. Furthermore, economic growth, population growth including the demand for housing and the impact of climate change means our forecasts show that the region will need 34% more water by 2044 than is available today. This combination of a growing water supply deficit and lack of supply resilience is not sustainable-we need a new source of water.
The solution is the Water Supply Project Eastern and Midlands Region. A critical national infrastructure project, it will have capacity to support water supply needs for up to 50% of our population. It will bring treated water from the Parteen Basin to Peamount in Dublin with the capacity for offtakes along the route in Tipperary, Offaly and Westmeath. It will also enable supplies serving Dublin to be redirected back locally in Carlow, Wicklow, Meath and Louth.

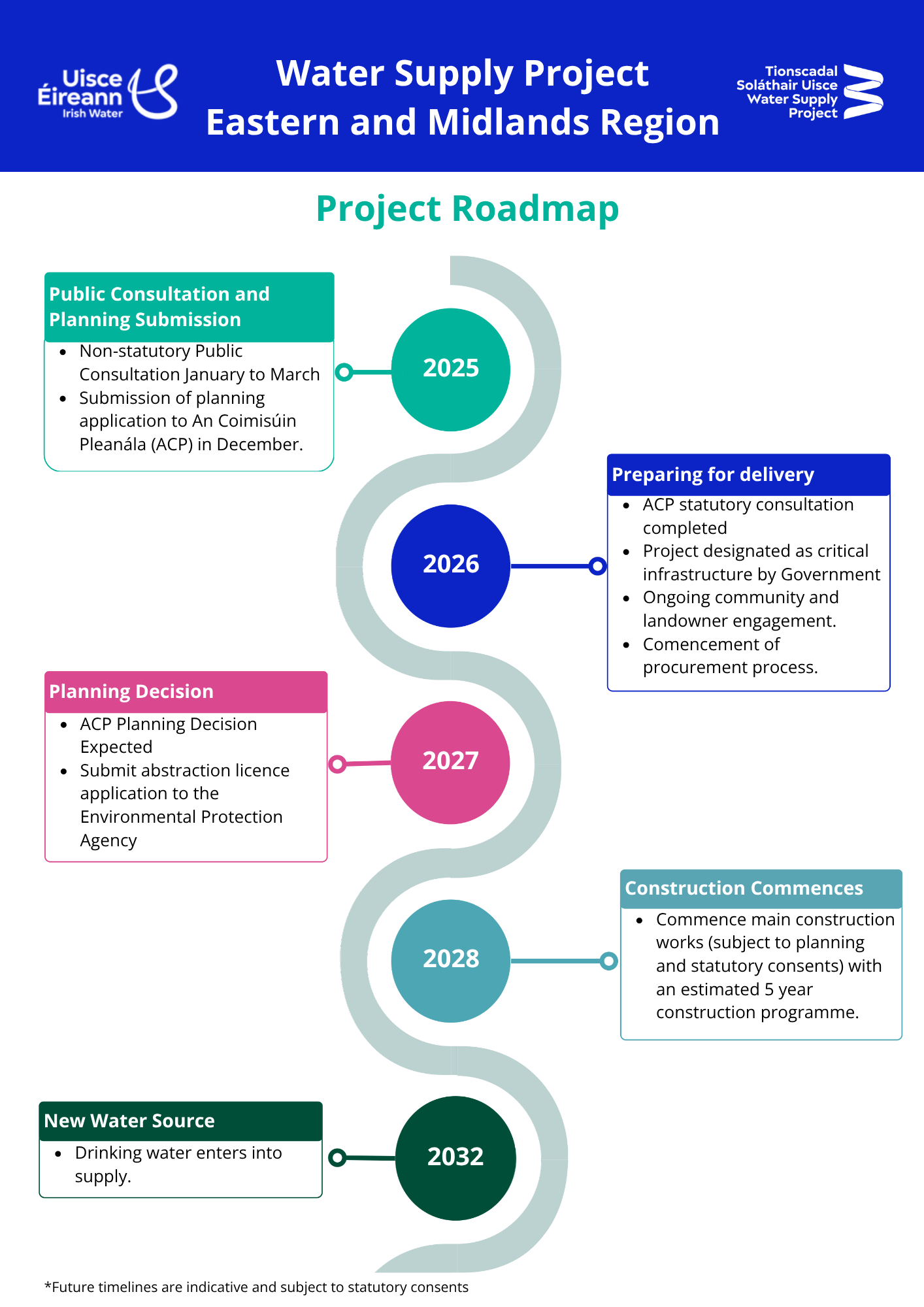

Status

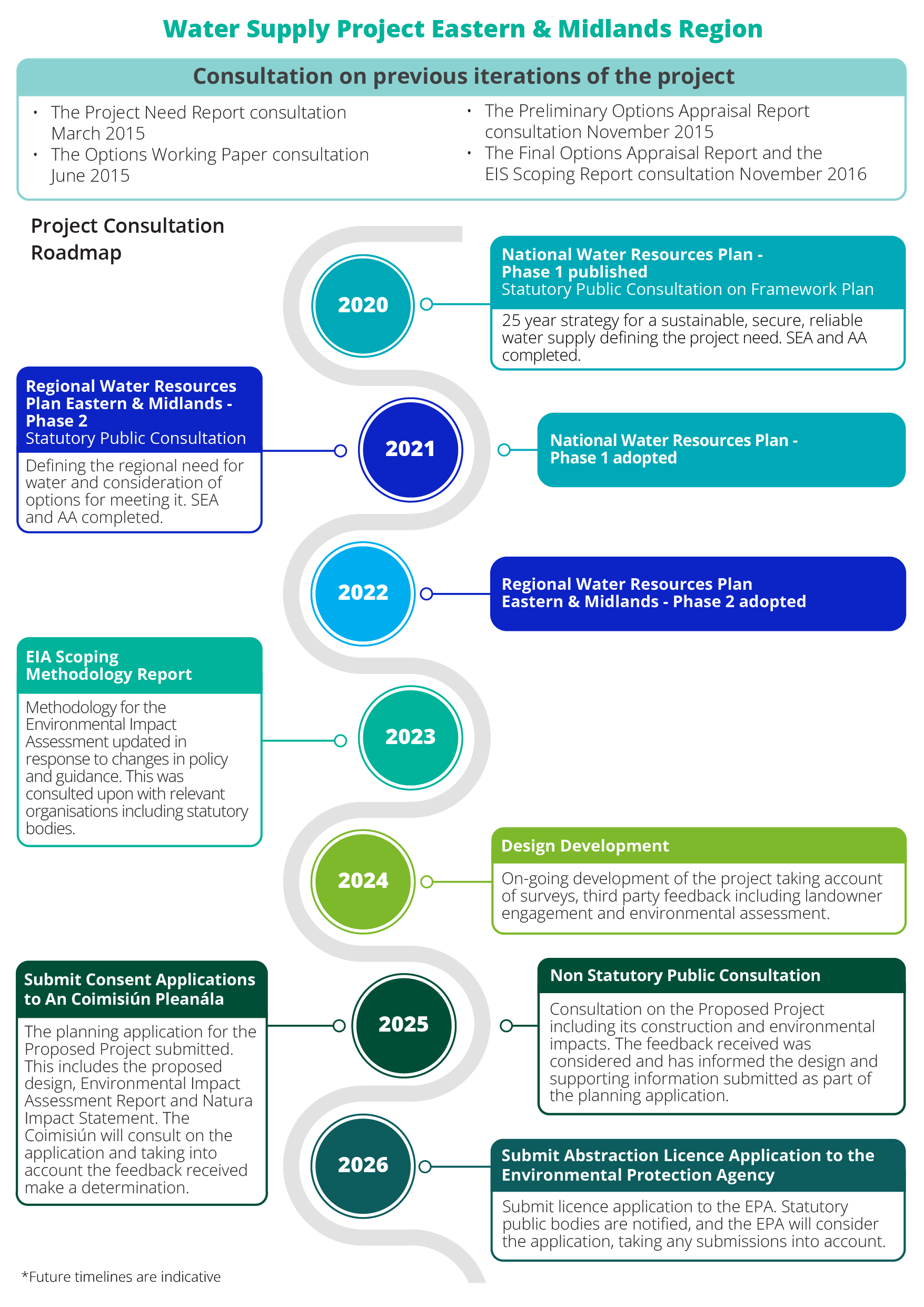

The Water Supply Project has approval in principle under the Government’s Infrastructure Guidelines. In December 2025, We have submitted a planning application to An Coimisiún Pleanála for the Water Supply Project Eastern and Midlands Region complete with an Environmental Impact Assessment Report (EIAR) and Natura Impact Statement (NIS). The planning application can be viewed and downloaded from here ‘watersupplyproject.ie’
Water Supply Project in 2025
To find out more, click below for a short 3 minute video.
The Project

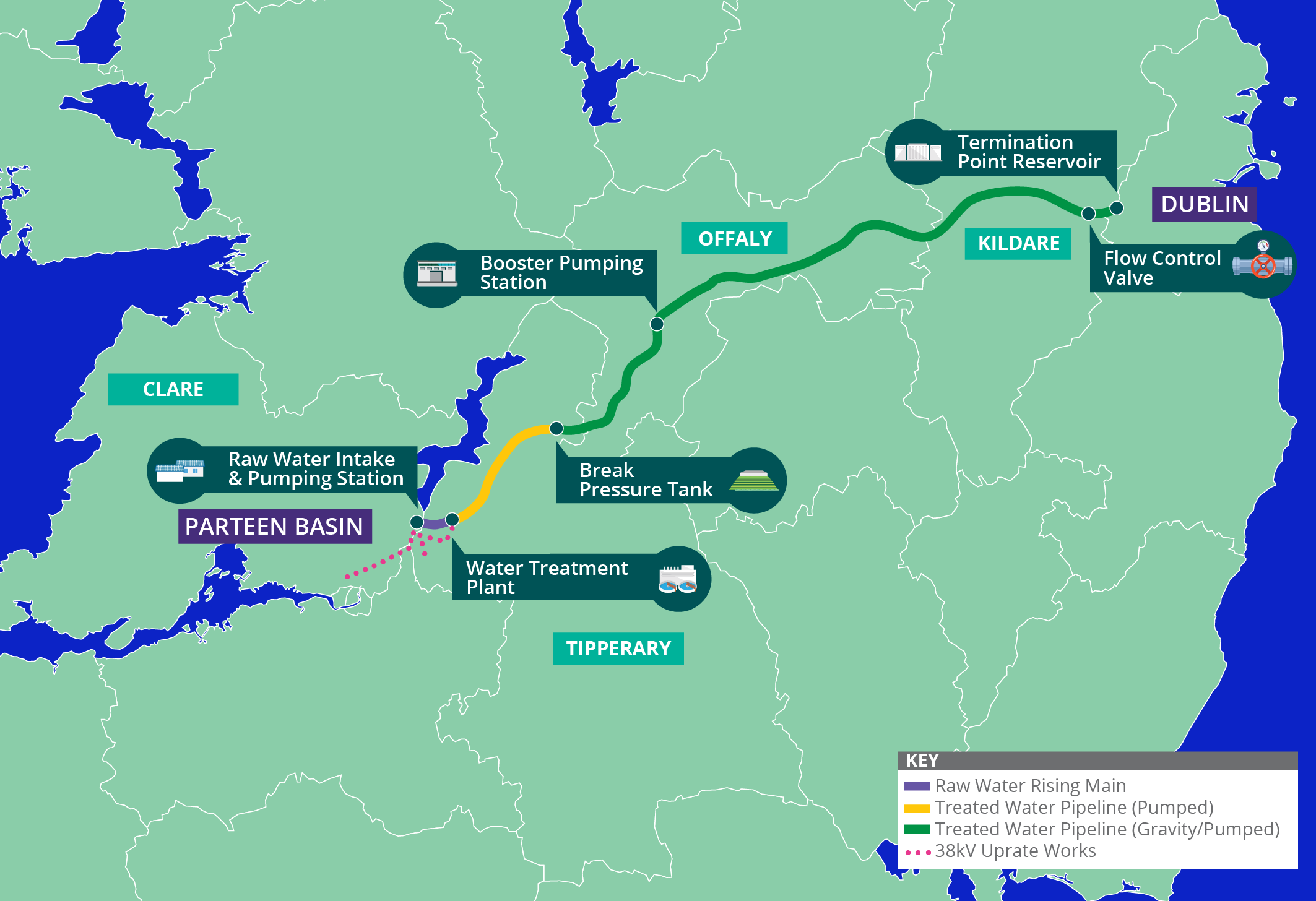

The proposed Water Supply Project Eastern and Midlands Region will abstract a maximum of 2% of the average flow of the River Shannon at Parteen Basin. The project is in line with the National Water Resources Plan (Framework Plan) and the Regional Water Resources Plan for the Eastern and Midlands Region. The Project will;
- Abstraction of water from the lower River Shannon at Parteen Basin in Co. Tipperary, downstream of Lough Derg
- Treatment of the abstracted water at Birdhill, Co. Tipperary
- Pipe the treated water through Tipperary, Offaly and Kildare to a termination point reservoir at Peamount in County Dublin
- Connect into the Greater Dublin Area water supply network, with capacity to provide water to communities along the route.

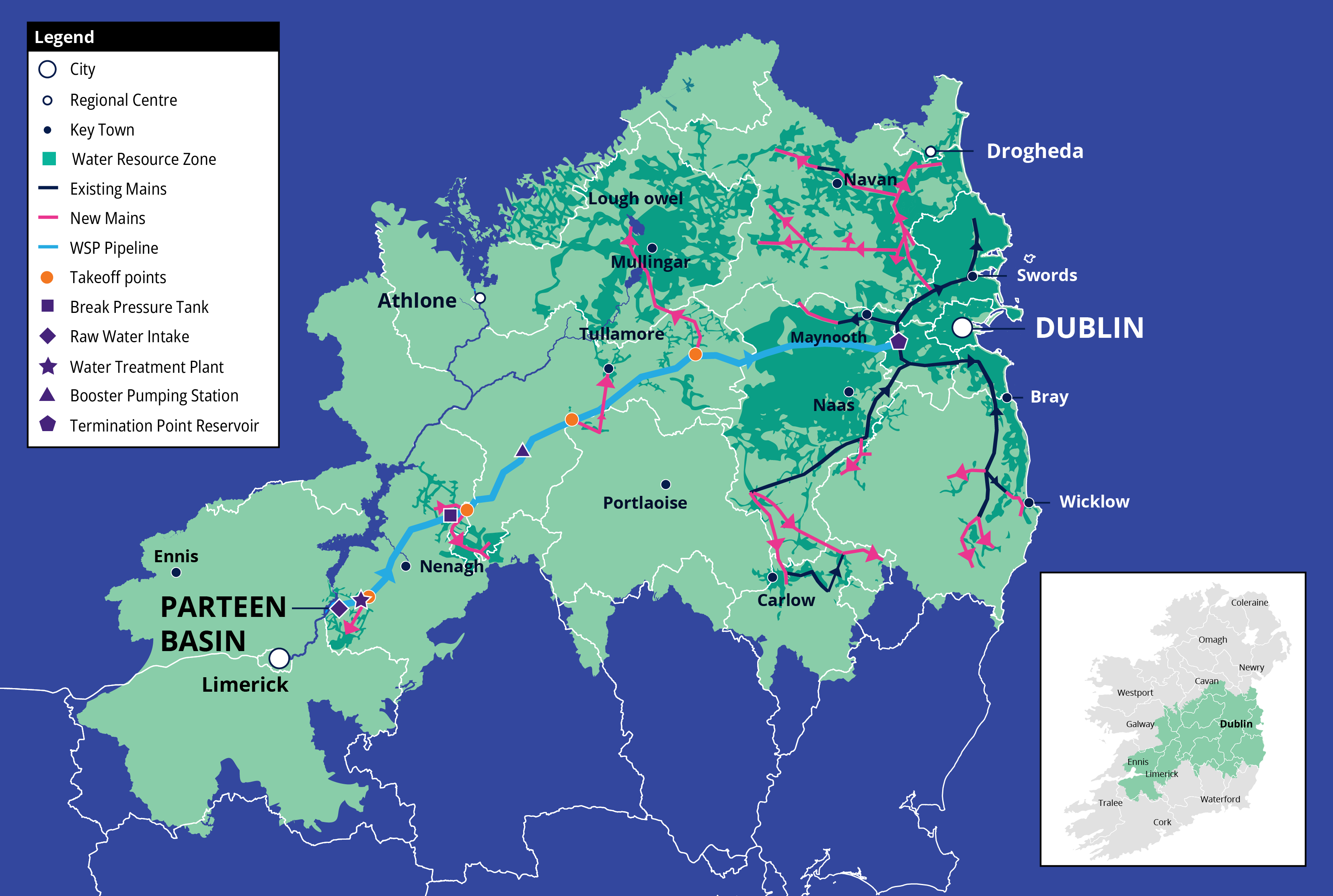

Eastern and Midlands regional in depth Water Supply Project Map
Community Engagement
Uisce Éireann have appointed a Community Liaison Officer (CLO) for the Water Supply Project Eastern and Midlands Region. The CLO is available to meet with members of the community, including at a number of drop-in information clinics over the coming months.
Planned Community Engagement Clinics: Details of future events will be updated below.
If you wish to speak with the Community Liaison Officer outside of these times, please contact the project team by emailing watersupply@water.ie.
Completed Community Engagement Clinics
| Date | Time | Location | Clinic venue |
| 03 February 2026 | 11am - 1pm | Co. Kildare | The Mill Celbridge Community Centre, Co. Kildare W23 P6P5 |
| 03 February 2026 | 5pm - 7pm | Co. Offaly | Killeigh Community Centre, Co. Offaly R35 V446 |
| 12 February 2026 | 11am - 1pm | Co. Tipperary | Nenagh Arts Centre, Co. Tipperary E45 CD52 |
| 12 February 2026 | 5pm - 7pm | Co. Clare | Ballina Killaloe Family Resource Centre, Co. Clare V94 W7X6 |
| 12 March 2026 | 11am - 1pm | Co. Kildare | Straffan Community Centre, Co. Kildare W23 V294 |
| 12 March 2026 | 5pm - 7pm | Co. Offaly | Kilcormac Community Hall, Co. Offaly R42 X894 |
| 19 March 2026 | 11am - 1pm | Co. Limerick | ACM Community Centre Castleconnell, Co. Limerick V94 FA0D |
| 19 March 2026 | 5pm - 7pm | Co. Tipperary | Thomas McDonagh Museum Cloughjordan, Co. Tipperary E53 EV29 |
| 09 April 2026 | 11am - 1pm | Co. Kildare | The Mill Celbridge Community Centre, Co. Kildare W23 P6P5 |
| 09 April 2026 | 5pm - 7pm | Co. Offaly | Killeigh Community Centre, Co. Offaly R35 V446 |
| 16 April 2026 | 11am - 1pm | Co. Tipperary | Nenagh Arts Centre, Co. Tipperary E45 CD52 |
| 16 April 2026 | 5pm - 7pm | Co. Clare | Ballina Killaloe Family Resource Centre, Co. Clare V94 W7X6 |
| 07 May 2026 | 12pm - 2pm | Co. Offaly | Killiegh Community Centre, R35 V446 |
| 07 May 2026 | 5pm - 7pm | Co. Kildare | Celbridge Community Centre, W23 P6P5 |
| 13 May 2026 | 12pm - 2pm | Co. Tipperary | Ardcroney Community Centre, E45 W250 |
| 13 May 2026 | 5pm - 7pm | Co. Limerick | ACM, Castle Street, Castleconnell V94 H90P (*Note room is in Castle Street, not Shannon House) |
| 10 June 2026 | 12:30pm - 2:30pm | Co. Clare | East Clare Community Co-operative, Main Street, Scarriff, Co. Clare V94 HPX9 |
| 10 June 2026 | 5pm - 7pm | Co. Galway | Portumna Town Community Hall, Clonfert Avenue, Portumna, Co. Galway H53 A0K8 |
| 17 June 2026 | 12pm - 2pm | Co. Limerick | Garryowen Community Development Project, 2 Garryowen Road, Limerick, V94 YW26 |
| 17 June 2026 | 5pm - 7pm | Co. Clare | Killaloe Ballina Family Resource Centre, The Green, Killaloe, Co. Clare V94 W7X6 |
| 08 July 2026 | 12pm - 2pm | Co. Dublin | St. Finian's Community Hall, Main Street Upper, Newcastle, Co. Dublin D22 Y5T7 |
| 08 July 2026 | 5pm - 7pm | Co. Meath | Dunboyne Community Centre, Station Road, Dunboyne, Co. Meath A86 XR59 |
| 29 July 2026 | 12pm - 2pm | Co. Tipperary | Birdhill Community Centre, Cooleen, Birdhill, Co. Tipperary V94 HPK5 |
| 29 July 2026 | 5pm - 7pm | Co. Limerick | ACM, Castle Street, Castleconnell, Co. Limerick V94 H90P |
| 26 August 2026 | 12pm - 2pm | Co. Clare | Killaloe Ballina Family Resource Centre, The Green, Killaloe, Co. Clare V94 W7X6 |
| 26 August 2026 | 5pm - 7pm | Co. Tipperary | Thomas McDonagh Museum Cloughjordan, Co. Tipperary E53 EV29 |
| 16 September 2026 | 12pm - 2pm | Co. Galway | Portumna Town Hall, Clonfert Avenue, Portumna, Co. Galway H53 WC93 |
| 16 September 2026 | 5pm - 7pm | Co. Clare | East Clare Community Co-operative, Main Street, Scarriff, Co. Clare V94 HPX9 |
| 23 September 2026 | 12pm - 2pm | Co. Offaly | Kilcormac Community Hall, Co. Offaly R42 X894 |
| 23 September 2026 | 5pm - 7pm | Co. Tipperary | Ardcroney Community Centre, E45 W250 |
| 14 October 2026 | 12pm - 2pm | Co. Limerick | ACM, Shannon House, Castleconnell, Co. Limerick V94 FA0D |
| 14 October 2026 | 5pm - 7pm | Co. Clare | Killaloe Ballina Family Resource Centre, The Green, Killaloe, Co. Clare V94 W7X6 |
| 21 October 2026 | 12pm - 2pm | Co. Offaly | Edenderry Parish Centre, St Mary's Rd, Edenderry, R45 E840 |
| 21 October 2026 | 5pm - 7pm | Co. Kildare | The Mill Celbridge Community Centre, Co. Kildare W23 P6P5 |
Landowner Information
A landowner handbook is available to provide landowners with specific information including an overview of the proposed project, as well as detailed information on construction and post construction phases.
All landowners along the proposed project route have been assigned a dedicated Landowner Liaison Officer, who have been advising landowners on the progress of route development and technical design, as well as arranging access for environmental and ground investigation surveys. The Landowner Liaison Officers will continue to provide landowners with a dedicated point of contact throughout the planning, construction and reinstatement phases.
Contact details have been shared with all landowners, however please email mpwayleaves@water.ie should you need any further information.
